Case Studies

How institutional mandates actually get closed in South India.

Three anonymised mandates. The same playbook that closed ₹300 Cr+ for the world’s largest alternative asset manager — reconstructed for capital partners evaluating the firm.

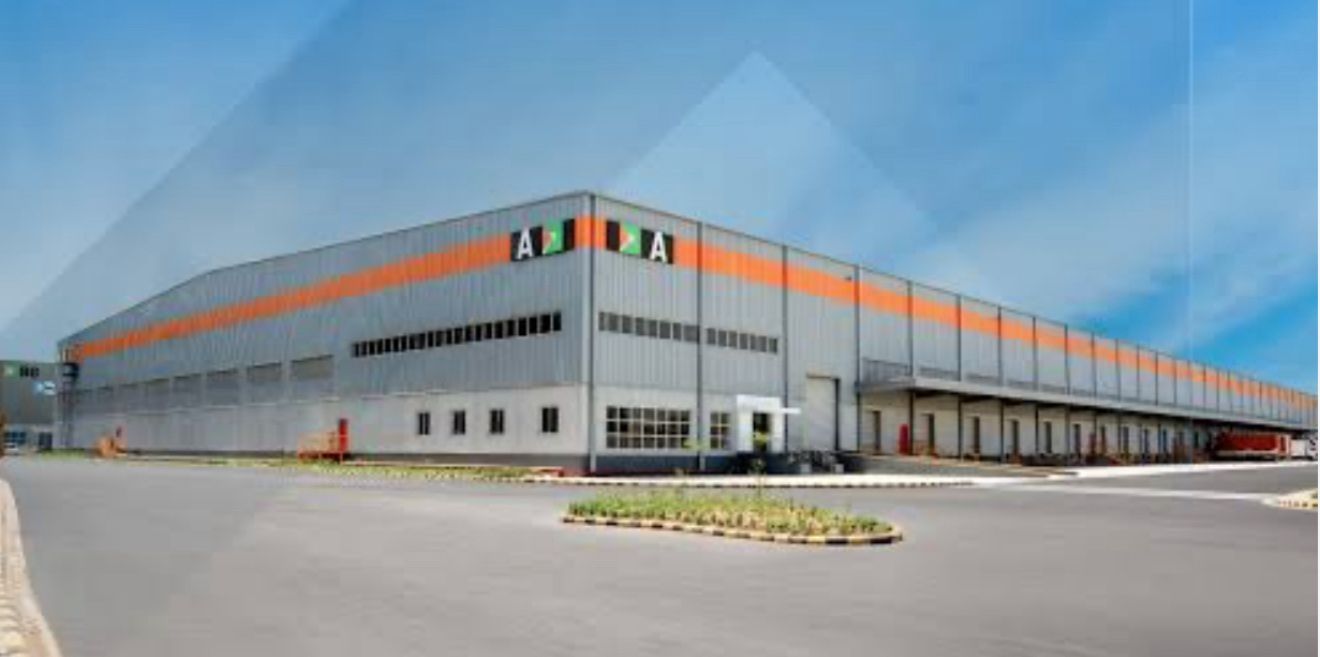

Grade A institutional warehouse facade, North Chennai (Redhills) logistics corridor — fully developed.
Case 01Institutional Land Aggregation · Development Management2023–2025

From 25+ acres of fragmented title to a fully operational ~500,000 sq ft Grade A facility.

Situation

Blackstone required a contiguous parcel of institutional-grade industrial land along a North Chennai logistics corridor. Local supply was fragmented across 40+ private holders, with overlapping pattadar claims and a six-month informal pricing inflation cycle already underway. Blackstone also required a partner capable of carrying the asset from origination through construction supervision and handover, not a brokerage hand-off.

Mandate

Originate, validate and aggregate a single deployable parcel of more than 25 acres within an agreed land budget for Blackstone — fully title-clear, ready for institutional underwriting — and then deliver the development end-to-end through approvals, construction supervision and handover to an operating asset.

Approach
  1. 01Mapped 20+ parcels against revenue, zoning and corridor master plans before approaching the aggregators.
  2. 02Brought in an interim investor to aggregate the land and ring-fence intermediaries to suppress price discovery leakage.
  3. 03Title diligence sequenced ahead of price commitment — eliminated 40% of parcels before any LOI.
  4. 04Held the land in an SPV to ease eventual acquisition by Blackstone.
  5. 05Initiated warehouse development approvals well before the actual acquisition by Blackstone.
  6. 06Supported Blackstone on clearances, project estimation, micro-market mapping to tenants and the full monetisation strategy.
  7. 07Carried the project into execution as development manager — design coordination, contractor tendering, construction supervision, cost and schedule control.
  8. 08Drove the project to full handover and operating readiness — ~500,000 sq ft of Grade A warehousing now fully operational.
Outcome
Aggregated
25+ acres
Developed area
~500,000 sq ft
Engagement scope
Origination → Handover
Status
Fully operational
Sellers consolidated
40+
Closed under budget
Yes
Lesson

Origination is not brokerage, and development management is not construction. The outcome here was decided in the first three months of land work, and again in the first sixty days of execution — long before the first panel was cast.

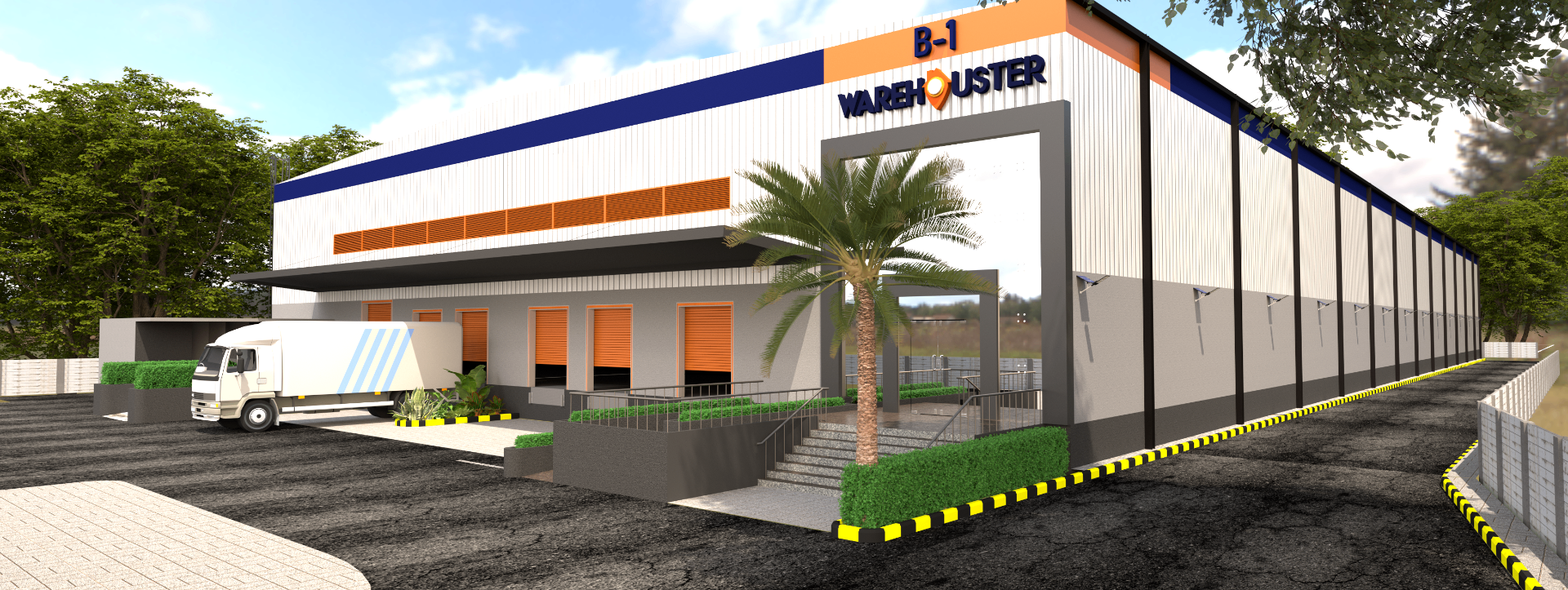

Britannia built-to-suit warehouse rendering, Puducherry corridor.
Case 02Built-to-Suit Delivery2025–2026

Delivering a 72,000 sq. ft. built-to-suit facility under an aggressive 10-month timeline.

Situation

Britannia Industries required a dedicated 72,000 sq. ft. built-to-suit warehouse and distribution facility in a Tier-2/Tier-3 market along the Southern India logistics corridor near Puducherry. Despite evaluating multiple sites, the client had been unable to identify a parcel that satisfied location, approval, development and delivery requirements. Site identification commenced in November 2025 with operations required by August 2026.

Mandate

Identify, acquire and institutionalise a suitable industrial land parcel, secure all development approvals, commence construction immediately and deliver a fully operational 72,000 sq. ft. built-to-suit facility within the client's required timeline.

Approach
  1. 01Ran rapid micro-market analysis across industrial clusters surrounding the Puducherry corridor to identify viable development locations.
  2. 02Shortlisted and secured the most suitable parcel based on logistics access, workforce availability and future expansion potential.
  3. 03Fast-tracked land acquisition, title validation and land conversion to eliminate delays in project commencement.
  4. 04Initiated building plan approvals immediately on land finalisation, rather than waiting for conventional transaction milestones.
  5. 05Coordinated consultants, statutory authorities and stakeholders under a single execution framework.
  6. 06Commenced construction at the earliest possible stage to compress the overall delivery schedule.
  7. 07Managed development execution, stakeholder coordination and timeline monitoring against operational requirements.
Outcome
Built-to-suit facility
72,000 sq. ft.
Project type
BTS development
Timeline
Nov 2025 – Aug 2026
Delivery status
On schedule
Follow-on mandates
Coimbatore + Madurai
Lesson

Execution speed is rarely created during construction. It is created in the first 60 days — through decisive land selection, parallel approval management, and eliminating handoff delays between acquisition and development.

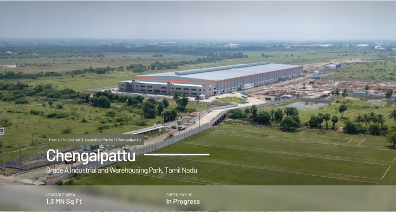

Aerial view of the Chengalpattu Grade A industrial and warehousing park under development.
Case 03Off-Market Institutionalisation2024

Creating an institution-ready 52-acre industrial park through structured acquisition and pre-leasing.

Situation

Horizon Industrial Parks sought to establish a large-scale industrial and warehousing park in the high-growth Chengalpattu corridor of South Chennai. The opportunity was an off-market 52-acre parcel with potential for 1.3 million sq. ft. of Grade A development — but it was not institution-ready. Ownership structuring, acquisition, approvals, conversion, investor alignment and tenant validation all had to be resolved before an institutional investor could underwrite it.

Mandate

Originate, structure and institutionalise a 52-acre off-market industrial land opportunity and create a de-risked acquisition platform — covering interim capital, aggregation, approvals, SPV creation, early tenant engagement and development management.

Approach
  1. 01Originated the off-market opportunity within the Chengalpattu corridor before the asset was broadly marketed, retaining control over pricing and structure.
  2. 02Introduced an interim investor to acquire and hold the land through the value-creation phase, isolating institutional capital from entitlement and execution risk.
  3. 03Institutionalised the land — acquisition, consolidation, title verification, documentation standardisation and removal of underwriting bottlenecks.
  4. 04Coordinated the full regulatory pathway: conversion, development approvals, infrastructure planning and compliance readiness.
  5. 05Created and maintained a dedicated SPV so the institutional investor could acquire control through an SPV transfer rather than an underlying land transaction.
  6. 06Ran parallel tenant origination — secured a soft commitment of ~400,000 sq. ft. (nearly one-third of the park) while acquisition was still in motion.
  7. 07Transitioned the institutionalised platform to the institutional investor via SPV transfer once approvals and readiness milestones were achieved.
  8. 08Continued post-acquisition development management — consultants, planning, execution support and investor reporting.
Outcome
Land acquired
52 acres
Development potential
1.3M sq. ft.
Tenant soft commitment
400,000 sq. ft.
Deal type
Off-market
Acquisition structure
SPV transfer
Timeline
Jan – Oct 2024
Lesson

Institutional investors prefer acquiring certainty, not complexity. The value creation here did not occur at acquisition — it occurred in the months spent converting raw land into an institution-ready platform with approvals, tenant demand, and a clean acquisition structure already in place.
